Our C_S43 study practice guide takes full account of the needs of the real exam and conveniences for the clients. Our C_S43 certification questions are close to the real exam and the questions and answers of the test bank cover the entire syllabus of the real exam and all the important information about the exam. Our C_S43 learning dump can stimulate the real examโ€™s environment to make the learners be personally on the scene and help the learners adjust the speed when they attend the real exam. To be convenient for the learners, our C_S43 Certification Questions provide the test practice software to help the learners check their learning results at any time.

SAP C_S43 Exam Syllabus Topics:

SectionWeightObjectives
Topic 1: Maintenance Processing35%- Manage maintenance notifications
  • 1. Create, process, complete notifications
  • 2. Notification types, priority, status management
- Configure and process maintenance orders
  • 1. Operations, components, capacity, cost settlement
  • 2. Order types, planning, scheduling, release
Topic 2: Inspection and Maintenance Processing10%- Manage inspection lots and results recording
  • 1. Inspection types, checklist processing
  • 2. Result recording, usage decision, follow-up actions
Topic 3: Preventive Maintenance25%- Manage task lists
  • 1. Operations, maintenance packages, scheduling parameters
  • 2. Create, maintain, assign task lists
- Configure and run maintenance plans
  • 1. Single-cycle, strategy-based, multiple-counter plans
  • 2. Scheduling, call objects, plan updates
Topic 4: Organizational Structures and Master Data20%- Define and configure organizational units
  • 1. Planner groups, maintenance planning groups
  • 2. Maintenance plant, planning plant, work centers
- Manage technical objects
  • 1. BOMs, material assignment, classification
  • 2. Functional locations, equipment, serial numbers
Topic 5: Integration and Reporting10%- Use standard reports and analytics
- Integrate with finance, logistics, and procurement

>> C_S43 Valid Test Labs <<

C_S43 New Questions, C_S43 Reliable Braindumps Book

As the quick development of the world economy and intense competition in the international, the world labor market presents many new trends: companyโ€™s demand for the excellent people is growing. As is known to us, the C_S43 certification is one mainly mark of the excellent. If you donโ€™t have enough ability, it is very possible for you to be washed out. On the contrary, the combination of experience and the C_S43 Certification could help you resume stand out in a competitive job market.

SAP Certified Implementation Consultant - SAP S/4HANA Cloud Private Edition, Asset Management (C_S43_2601) Sample Questions (Q10-Q15):

NEW QUESTION # 10
Create a Maintenance Order with Checklists
The project team evaluates during the implementation project Maintenance Orders with Checklists in SAP S
/4HANA Asset Management. The following features need to be checked:
* Create a Maintenance Order with Checklist
* Display a Maintenance Order with automatically generated Object List and Checklist.
* Create a Maintenance Order using an Order Type which is already configured for the checklist process.
Use the following data:

* Display the previously created Maintenance Order with automatically generated Object List and Checklist.

Answer:

Explanation:
See the Explanation for complete Solution of this Task.
Explanation:
Task 12 Overview
In this task, you will create a maintenance order using a specific order type configured for the checklist process. The system will then automatically generate an object list and a corresponding checklist based on the equipment and task list assigned.
Step 1: Create a Maintenance Order with Checklist
You need to create a new order using a functional location and a specific task list that triggers the checklist functionality.
* Access the Transaction : Use transaction code IW31 (Create Maintenance Order).
* Initial Screen :
* Order Type : Select an order type already configured for the checklist process (typically PM01 or a specific custom type designated for checklists in your training environment).
* Press Enter .
* Enter Header and Location Data :
* Functional Location : Enter 48-01-PRD-01-03-HD .
* Description : Enter a relevant description (e.g., Pump Checklist Maintenance GR48).
* Assign the Task List :
* Go to the Operations tab or find the task list assignment section.
* General Maintenance Task List : Enter A / T-PMCLEN / 1 .
* Press Enter to validate.
* Save : Click the Save (floppy disk) icon.
Explanation : By assigning this specific functional location and general task list, you are triggering the
"Checklist" integration. The system uses the classification data you set up in Task 11 to determine that a checklist (inspection lot) is required for this job.
Step 2: Display and Verify the Checklist
After saving, you must verify that the system correctly generated the technical components of the checklist.
* Display the Order : Use transaction code IW33 and enter the order number you just created.
* Verify the Object List :
* Navigate to the Object List tab.
* You should see the equipment or functional location listed here with a link to the checklist.
* Verify the Checklist :
* Look for a button or tab labeled Checklists or Inspection Lot within the order.
* The system should show that a checklist has been automatically generated for the repair operations.
Explanation : The goal of this step is to confirm that the "Object List" and "Checklist" were created automatically by the system. This proves the background configuration for QM (Quality Management) integration is working correctly with your maintenance order

NEW QUESTION # 11
Task: 5
Configure and create a Maintenance Notification
The project team evaluates during the implementation project the Maintenance Notifications in SAP S
/4HANA Asset Management. The following features need to be checked:
* Configure and create a Maintenance Notification
* Assign catalog specific data to a Maintenance Notification
* Create a Maintenance Notification and save it. Use the following information:

* Assign the following data to the just created notification:

Answer:

Explanation:
See the Explanation for complete Solution of this Task.
Explanation:
Task 5 Overview
The project team is evaluating Maintenance Notifications in SAP S/4HANA Asset Management. This task involves creating a notification and assigning catalog-specific data to it.

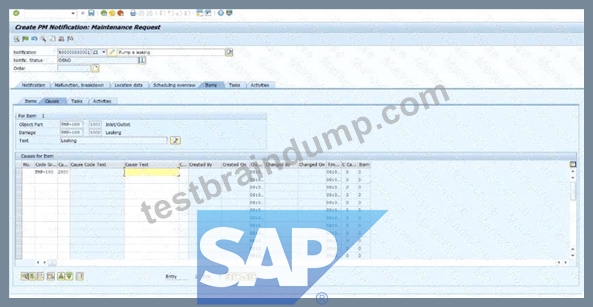

Step 1: Create the Maintenance Notification
In this step, you will record a technical problem in the system.
* Access the Transaction : Use transaction code IW21 (Create Maintenance Notification) in the SAP GUI or the corresponding Fiori app.
* Initial Screen :

* Notification Type : Enter Z1 .
* Press Enter .
* Enter General Data :
* Description : Enter Pump is leaking .
* Priority : Select High .
* Equipment : Enter T-PA48 .
* Save : Click the Save (floppy disk) icon to generate a notification number.
Explanation : Creating a notification is the first step in the maintenance process. It documents the "what" (leaking pump), the "how critical" (high priority), and the "where" (Equipment T-PA48).

Step 2: Assign Catalog Specific Data

Now you must assign technical codes to describe the damage precisely for future reporting and analysis.
* Access the Transaction : Use transaction code IW22 (Change Maintenance Notification) to open your recently created notification.
* Navigate to Item Data : Go to the Items tab or the relevant section for damage and causes.
* Enter Damage Details :

* Damage Code Group : PMP-100 .
* Damage Code : 1000 .
* Description : Leaking .
* Enter Object Part Details :
* Object Part Code Group : PMP-Z48 .
* Object Part Code : 1001 .
* Description : Inlet/Outlet .
* Enter Cause Details :
* Cause Code Group : PMP-248 .
* Cause Code : 2000 .
* Description : Material fatigue .
* Save : Click the Save icon to finalize the notification.
Explanation : Assigning catalog data categorizes the issue using standardized codes. This allows the company to run "Bad Actor" reports later to see, for example, how many pumps are failing due to "Material fatigue" versus "Operator error".

NEW QUESTION # 12
Task 6: Configure Maintenance Order Types and work with Maintenance Orders The project team evaluates during the implementation project Maintenance Orders in SAP S/4HANA Asset Management. The following features need to be checked:
* Configure a Maintenance Order Type and create a Maintenance Order
* Create a Time Confirmation a Maintenance Order
* Prepare a Maintenance Order for Completion
* Create a Maintenance Order and save it.
Note:
Make sure that you have maintained all required customizing settings for the Maintenance Order Type.
Use the following information at header level:

Plan a Maintenance Order Operation and use the following information:

* Create a Time Confirmation for the just created Maintenance Order. Use the following information:

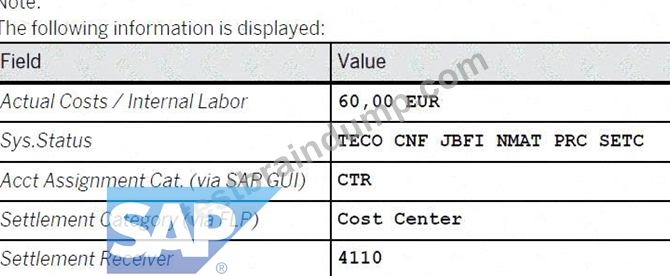

* Display the Actual Costs assigned to the just created Maintenance Order and set it to Technically Completed. Display the Settlement Rule.

Answer:

Explanation:
See the Explanation for complete Solution of this Task.
Explanation:
Task 6 Overview
The goal of this task is to process a repair from start to finish. You will convert the "leaking pump" notification into a work order, plan the labor, record the work performed, and technically close the file.
Step 1: Create the Maintenance Order from Notification
Instead of starting from scratch, we link the order to the notification you created in Task 5.
* Access the Transaction : Use transaction code IW31 .
* Initial Screen :
* Order Type : PM01.
* Notification : Enter your notification number (e.g., 10000147).
* Press Enter .
* Header Data :
* The description "Pump is leaking" should pull in automatically.
* Main Work Center : Ensure it is T-ME48.
Explanation : By entering the notification number, SAP automatically pulls in the equipment, functional location, and problem description, ensuring "data integrity" across the maintenance process.
Step 2: Plan the Operations (Labor)
You must tell the system how much effort the repair requires.
* Go to the Operations Tab .
* Enter Planning Data :
* Work : 2.
* Unit (Un) : H (Hours).
* Number : 1 (One person).
* Duration (Dur.) : 2 / Unit : H.
* Add Enhancement Data :
* Click the Additional Data tab - > Enhancement sub-tab.
* In the Field Key box, use the search (F4) to select 0000001 (User-defined fields).
* In the first text box ( Text 1 ), type: Industrial Z48.
Explanation : Planning the work allows the system to calculate the estimated cost of the repair. The
"Enhancement" data is used to store specific technical details (like the motor type) that aren't in the standard SAP fields.
Step 3: Release the Order
An order in "Created" (CRTD) status is just a plan. To start work, it must be "Released" (REL).
* Release : Look at the top toolbar and click the Green Flag icon .
* Verify Status : The "Sys.Status" field should now include REL.
* Save : Click the Save (floppy disk) icon.
Explanation : Releasing the order is the "Green Light" for the shop floor. It allows technicians to charge time to the job and warehouse staff to issue parts.
Step 4: Time Confirmation (Recording the Work)
Now we record that the repair is physically finished.
* Access the Transaction : Use transaction code IW41 .
* Enter Data :
* Order : Enter your order number (e.g., 4000395).
* Actual Work : 2 H.
* Check the boxes for Final Confirmation and No Remaining Work .
* Confirmation Text : Pump repaired and tested.
* Save : Click the Save icon.
Explanation : This step captures the "Actual Cost." SAP multiplies the 2 hours of labor by the hourly rate of work center T-ME48 to calculate exactly how much this repair cost the company.
Step 5: Technical Completion (TECO)
The final administrative step to close the repair file.
* Access the Transaction : Use transaction code IW32 .
* Complete Technically :
* Go to menu: Order > Functions > Complete > Complete (technically) .
* Click the Green Checkmark on the popup window.
* Save : Click the Save icon.
Explanation : TECO (Technical Completion) locks the order. It tells the system the asset is back in service and prevents any further labor or parts from being charged to this specific job.

NEW QUESTION # 13
Use Phase-Based Maintenance Processing
The project team evaluates during the implementation project Phase-Based Maintenance Processing in SAP S
/4HANA Asset Management. The following features need to be checked:
* Initiate and screen a Maintenance Notification
* Plan Maintenance Order and send it for approval
* Create a Maintenance Notification using an already available notification type which is suitable for phase-based maintenance and save it.
Use the following data:

* Screen and accept the just created Maintenance Notification.
* Create an Order (Phase-based) for your accepted notification and submit it for approval.
Use the following data:

Answer:

Explanation:
See the Explanation for complete Solution of this Task.
Explanation:
Task 10 Overview
This task evaluates your ability to manage the newer, phase-led maintenance workflow in SAP S/4HANA.
Unlike the traditional "emergency" repair you did earlier, this process includes formal screening and approval steps Step 1: Create a Phase-Based Maintenance Notification In this step, you initiate the request.
* Access the Transaction : Use transaction IW21 or the Fiori app Create Maintenance Request .
* Select Notification Type : Use a type configured for phase-based maintenance (typically Y1 - Maintenance Request ).
* Enter the Following Data :
* Technical Object : T-PB48
* Description : Defective pump (phase-based)
* Current Location : Production Line 1
* Detection Method : Continuous Condition Monitoring
* Operational Effect : Production restricted
* Save : Note the notification number generated.
Explanation : This step "initiates" the maintenance process. In phase-based maintenance, the notification starts in the Initiation phase, where it must be reviewed before any work is planned.
Step 2: Screen and Accept the Notification
As a "Maintenance Coordinator," you must now review the request.
* Access the Fiori App : Open Screen Maintenance Requests .
* Locate Your Notification : Find the notification you just created for T-PB48.
* Perform Screening :
* Review the details to ensure they are complete.
* Click Accept to move it to the next phase.
Explanation : "Screening" is a quality gate. It ensures that the maintenance team only spends time planning valid, well-described issues. Once accepted, the notification moves from the Initiation phase to the Screening phase and finally becomes available for planning.
Step 3: Create and Plan the Phase-Based Order
Now you will create the formal work order for the accepted request.
* Create Order : From within the accepted notification, or using the Manage Maintenance Backlog app, choose to Create Order .
* Enter Planning Data :
* Technical Object : T-PB48

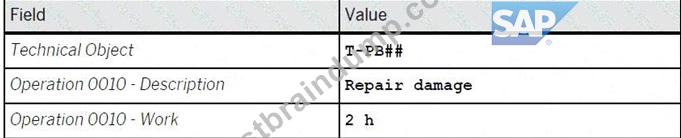

* Operation 0010 Description : Repair damage
* Operation 0010 Work : 2 h
* Submit for Approval : Look for the Submit for Approval button at the top of the order screen.
Explanation : This step moves the order into the Planning phase. By submitting it for approval, you are requesting the budget and resources to perform the work. The order status will change to indicate it is
"Waiting for Approval"

NEW QUESTION # 14
Task 4: Configure and create Technical Objects
The project team evaluates during the implementation project Technical Object structures in SAP S/4HANA Asset Management. The following features need to be checked:

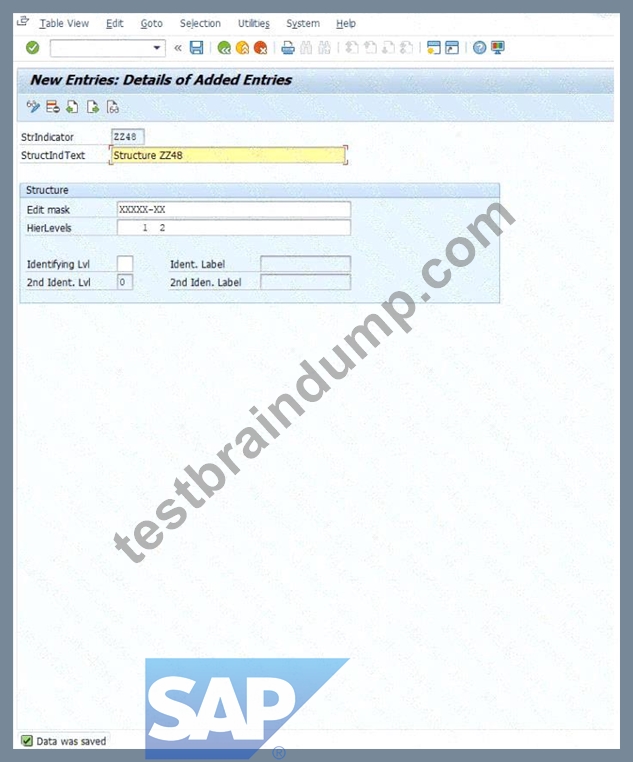

* Configure and create Functional Locations
* Create, serialize and install Equipment

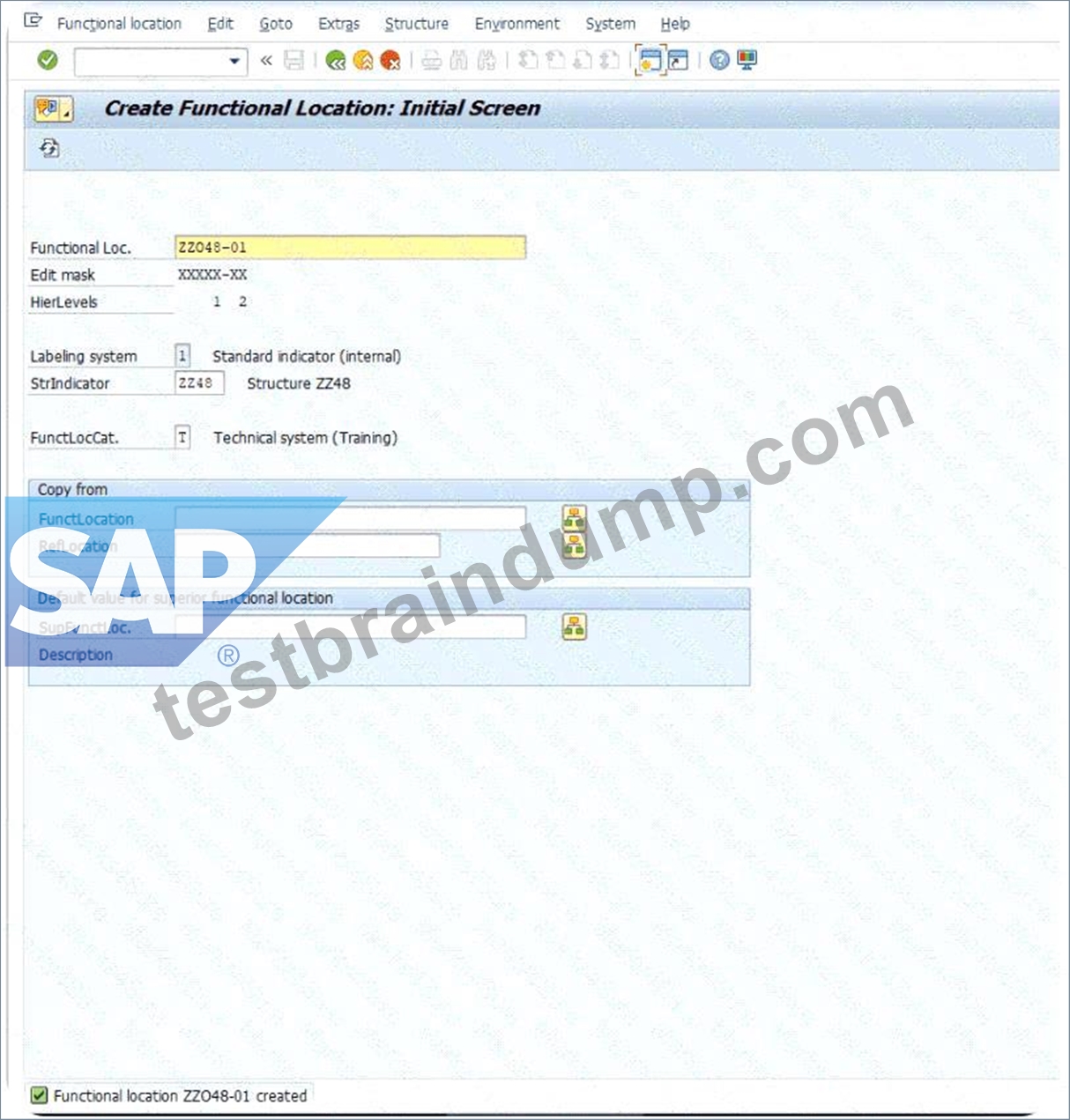

* Create Functional Location master record ZZ0##-01 and save it. Use the following information:

* Create Equipment master record EQUI-## and save it. Use the following information:

* Serialize the just created Equipment master record EQUI-## . Use the following data:

* Install Equipment EQUI-## at the Functional Location 00-01-ASS-02 .

Answer:

Explanation:
See the Explanation for complete Solution of this Task.
Explanation:
Task 4: Configure and create Technical Objects
This task evaluates your ability to structure and manage the physical and functional hierarchy of assets in SAP S/4HANA Asset Management.
Step 1: Create Functional Location Master Record
A Functional Location represents the area at which a maintenance task is to be performed.
* Access the Transaction : Use transaction code IL01 (Create Functional Location).
* Enter Initial Data :
* Functional Location : ZZ048-01.
* Structure Indicator : ZZ48.
* Functional Location Category : T.
* Press Enter .

* Enter General Data :
* Description : Production Line Z48.
* Enter Location and Organization Data :
* Maintenance Plant : 1020.
* Cost Center : 4110.
* Planning Plant : 1020.
* Planner Group : Z48.
* Main WorkCtr : T-ME48.
* Work Center Plant : 1010.
* Save : Click the Save icon.
Explanation : By creating this record, you define a specific functional area within Plant 1020 where maintenance costs and history will be tracked for all equipment installed there.

Step 2: Create Equipment Master Record
Equipment represents an individual physical object that is maintained as an autonomous unit.
* Access the Transaction : Use transaction code IE01 (Create Equipment).
* Enter Initial Data :
* Equipment : EQUI-48.
* Equipment Category : T.
* Press Enter .

* Enter General Data :
* Description : Drive Motor GR48.
* Save : Click the Save icon.
Explanation : This step creates a master record for a physical asset-a drive motor-allowing you to track its individual lifecycle, independent of where it is currently installed.

Step 3: Serialize the Equipment
Serialization links a piece of equipment to a specific material and unique serial number for inventory management and tracking.
* Access the Transaction : Use transaction code IE02 (Change Equipment) and enter EQUI-48.
* Navigate to Serial Data : Go to the SerData (Serial Data) tab.
* Enter Serialization Data :
* Material : T-PM8000.
* Serial Number : EQUI-48.
* Save : Click the Save icon.
Explanation : Linking the motor to Material T-PM8000 enables the system to track this specific asset as a serialized part, which is essential for warehouse movements and warranty tracking.

Step 4: Install Equipment at a Functional Location
This establishes the relationship between the physical asset (Equipment) and the functional area where it is operating.
* Access the Transaction : Use transaction code IE02 (Change Equipment) for EQUI-48.
* Modify Installation Location :
* Click on the Structure tab.
* Find the FunctLoc field.
* Enter the location: 00-01-ASS-02.
* Save : Click the Save icon.
Explanation : This installation "plugs" your drive motor into the functional hierarchy at location 00-01-ASS-02. From this point forward, any maintenance performed on this motor will be automatically associated with that location's history.

NEW QUESTION # 15
......

Everybody knows that SAP is an influential company with high-end products and best-quality service. It will be a long and tough way to pass C_S43 exam test, especially for people who have no time to prepare the C_S43 Questions and answers. So choosing right C_S43 dumps torrent is very necessary and important for people who want to pass test at first attempt.
