No matter in the day or on the night, you can consult us the relevant information about our CAPM preparation exam through the way of chatting online or sending emails. I’m sure our 24-hour online service will not disappoint you as we offer our service 24/7 on our CAPM Study Materials. And we will give you the most considerate suggestions on our CAPM learning guide with all our sincere and warm heart.
| Section | Weight | Objectives |
|---|---|---|
| Topic 1: Predictive, Plan-Based Methodologies | 30% | - Plan-Driven Process Implementation
|
| Topic 2: Project Management Fundamentals and Core Concepts | 50% | - Project Cost Management
|
| Topic 3: Agile and Hybrid Methodologies | 20% | - Agile Principles and Mindset
|
For years our company is always devoted to provide the best CAPM practice questions to the clients and help them pass the test CAPM certification smoothly. Our company tried its best to recruit the famous industry experts domestically and dedicated excellent personnel to compile the CAPM cram guide and serve for our clients wholeheartedly. Our company sets up the service tenet that customers are our gods and the strict standards for the quality of our CAPM training materials.
NEW QUESTION # 505
When would resource leveling be applied to a schedule model?
Answer: C
Explanation:
Section: Volume C
Explanation:
6.6.2.2 Critical Path Method
The critical path method, which is a method used to estimate the minimum project duration and determine the amount of scheduling flexibility on the logical network paths within the schedule model. This schedule network analysis technique calculates the early start, early finish, late start, and late finish dates for all activities without regard for any resource limitations by performing a forward and backward pass analysis through the schedule network, as shown in Figure 6-18. In this example the longest path includes activities A, C, and D, and, therefore, the sequence of A-C-D is the critical path. The critical path is the sequence of activities that represents the longest path through a project, which determines the shortest possible project duration. The resulting early and late start and finish dates are not necessarily the project schedule, rather they indicate the time periods within which the activity could be executed, using the parameters entered in the schedule model for activity durations, logical relationships, leads, lags, and other known constraints. The critical path method is used to calculate the amount of scheduling flexibility on the logical network paths within the schedule model.
On any network path, the schedule flexibility is measured by the amount of time that a schedule activity can be delayed or extended from its early start date without delaying the project finish date or violating a schedule constraint, and is termed "total float." A CPM critical path is normally characterized by zero total float on the critical path. As implemented with PDM sequencing, critical paths may have positive, zero, or negative total float depending on constraints applied. Any activity on the critical path is called a critical path activity. Positive total float is caused when the backward pass is calculated from a schedule constraint that is later than the early finish date that has been calculated during forward pass calculation. Negative total float is caused when a constraint on the late dates is violated by duration and logic. Schedule networks may have multiple near-critical paths. Many software packages allow the user to define the parameters used to determine the critical path(s).
Adjustments to activity durations (if more resources or less scope can be arranged), logical relationships (if the relationships were discretionary to begin with), leads and lags, or other schedule constraints may be necessary to produce network paths with a zero or positive total float. Once the total float for a network path has been calculated, then the free float-the amount of time that a schedule activity can be delayed without delaying the early start date of any successor or violating a schedule constraint-can also be determined. For example the free float for Activity B, in Figure 6-18, is 5 days.
NEW QUESTION # 506
What tool should a project manager use to efficiently manage project resources?
Answer: B
NEW QUESTION # 507
How can a project manager evaluate project team development?
Answer: D
Explanation:
According to the PMBOKGuide, the Develop Team process includes the specific output of Team Performance Assessments. As a project manager implements development strategies (such as training, team building, and ground rules), they must evaluate the effectiveness of these efforts.
* Purpose of Assessments: The formal evaluation of the project team ' s effectiveness. This is not just about technical output, but about how the team is functioning as a cohesive unit.
* Evaluation Criteria: Successful team development is measured by:
* Improvements in individual skills that allow members to perform tasks more effectively.
* Improvements in competencies and personality attributes that help the team work together.
* Reduced staff turnover rate.
* Increased team cohesiveness where members share information and help each other.
* Continuous Feedback: These assessments are used to identify the specific training, coaching, or changes required to improve team performance.
Analysis of Other Options:
* B. Hold weekly meetings to engage every member: While meetings are a tool for communication and engagement, the meeting itself is an activity, not a method of evaluation. You would use the results of those meetings to help inform the performance assessment.
* C. Complete a personal skill assessment on each team member: While individual assessments (like the Individual Development Plan) are part of the process, they only measure one person. The question asks about project team development, which requires a broader assessment of the group ' s collective synergy.
* D. Provide recognition awards to team members: This is a Tool and Technique used during the Develop Team process to motivate and reinforce positive behavior. It is a reward for performance, not the formal analytical tool used to evaluate the overall development of the team.
NEW QUESTION # 508
During which knowledge area stage would a project manager close all contracts appropriately and then close the phase?
Answer: A
Explanation:
Section: Volume E
Explanation
NEW QUESTION # 509

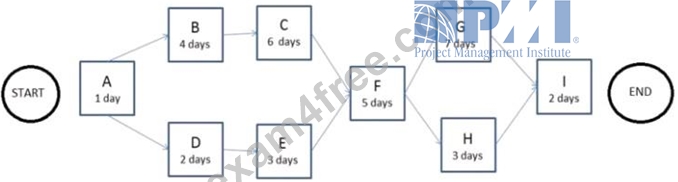

The following is a network diagram for a project.
What is the critical path for the project?
Answer: D
NEW QUESTION # 510
......
The CAPM certificate is hard to get. If you really crave for it, our CAPM guide practice is your best choice. We know it is hard for you to make decisions. You will feel sorry if you give up trying. Also, the good chance will slip away if you keep standing still. Our price is reasonable and inexpensive. You totally can afford for our CAPM Preparation engine. And we give some discounts from time to time, so you can buy at a more favorable price.
