In recent years, fierce competition agitates the forwarding IT industry in the world. And IT certification has become a necessity. If you want to get a good improvement in your career, The method that using the Prep4awayโ€™s SAP C_S43_2601 Exam Training materials to obtain a certificate is very feasible. Our exam materials are including all the questions which the exam required. So the materials will be able to help you to pass the exam.

SAP C_S43_2601 Exam Syllabus Topics:

SectionWeightObjectives
Maintenance Processing30%- Maintenance orders
  • 1. Operations, components, capacity planning
    • 2. Order types, control keys, settlement rules
      • 3. Time confirmation, technical completion, business completion
        - Maintenance notifications
        • 1. Create, process, and complete notifications
          • 2. Configure notification types, catalogs, priorities
            Organizational Structures and Master Data20%- Define and configure organizational units
            • 1. Planner groups, maintenance planning groups
              • 2. Maintenance plants, planning plants, work centers
                - Manage technical objects
                • 1. Classification and characteristics
                  • 2. Functional locations, equipment, serial numbers
                    Maintenance Execution and Integration15%- Work clearance management and safety
                    • 1. Permits, safety measures, risk assessments
                      - Integration with other modules
                      • 1. Materials Management, Finance, Controlling
                        • 2. Project System, Quality Management
                          Reporting and Analytics10%- Standard reports and analytics
                          • 1. Maintenance history, cost analysis, KPIs
                            - Fiori apps and dashboards
                            • 1. Asset management dashboards, operational reporting
                              Preventive Maintenance25%- Maintenance plans and scheduling
                              • 1. Scheduling parameters, call objects, maintenance cycles
                                • 2. Single-cycle, multiple-counter, strategy plans
                                  - Task lists and maintenance strategies
                                  • 1. Assign task lists to plans and orders
                                    • 2. Create and maintain task lists

                                      >> SAP C_S43_2601 Materials <<

                                      Reliable C_S43_2601 Exam Syllabus, C_S43_2601 Reliable Test Pdf

                                      If you want to get a higher salary or a promotion on your position, you need to work harder! Purchase our C_S43_2601 learning materials and stick with it. Then your strength will protect you. For as long as you study with our C_S43_2601 exam questions, then you will find that the content of our C_S43_2601 praparation braindumps is all the hot hit of the newest knowledage and keypoints of the subject, you will learn so much to master the skills which will help you solve your problems in your work. And besides, you can achieve the certification for sure with our C_S43_2601 study guide.

                                      SAP Certified Implementation Consultant - SAP S/4HANA Cloud Private Edition, Asset Management (C_S43_2601) Sample Questions (Q10-Q15):

                                      NEW QUESTION # 10
                                      Schedule a Maintenance Plan
                                      The project team evaluates during the implementation project the scheduling of Maintenance Plans in SAP S
                                      /4HANA Asset Management. The following features need to be checked:
                                      Schedule a Maintenance Plan
                                      Display a generated Maintenance Order
                                      Schedule the previously created Maintenance Plan. The following prerequisites have to be met:
                                      The next upcoming call is the 4 MON Maintenance Package
                                      Calculate the Completion Date of the last Maintenance Package as follows: Today's date minus 4 weeks (e.g.
                                      today's date: 15th of December > > > Completion Date: 17th of November) The Call Date is always 10 days before the Plan Date.
                                      Note:
                                      Check your Maintenance Plan and adapt it, if necessary, before you schedule it.
                                      Check the following information in the generated Maintenance Order:
                                      number of order operations: 2
                                      Maintenance Plan: number of the previously created Maintenance Plan
                                      Last Included Task List: A / TL-## / 1

                                      Answer:

                                      Explanation:
                                      See the Explanation for complete Solution of this Task.
                                      Explanation:
                                      Task 9 Overview
                                      The goal of this task is to trigger the maintenance schedule you built in Task 8 so that the system generates an actual work order. You must meet specific scheduling conditions to ensure the right maintenance cycle (the 4- month package) is triggered.
                                      Step 1: Adapt Scheduling Parameters (IP02)
                                      Before starting the schedule, you must ensure the "Call Date" rules are correct.
                                      * Transaction : Enter IP02 (Change Maintenance Plan).
                                      * Maintenance Plan : Enter the number you saved in Task 8 and press Enter .
                                      * Scheduling Parameters Tab :
                                      * Call Horizon : Adjust this so that the Call Date occurs exactly 10 days before the Plan Date.
                                      * Note: If your system uses percentages, you will need to calculate the percentage of the 4-month cycle that results in a 10-day lead time.
                                      * Save your changes.
                                      Step 2: Schedule the Plan (IP10)
                                      Now you will "start" the clock for this maintenance schedule.
                                      * Transaction : Enter IP10 (Schedule Maintenance Plan).
                                      * Maintenance Plan : Enter your plan number and press Enter .
                                      * Start Scheduling : Click the Start icon (or go to Maintenance plan > Scheduling > Start ).
                                      * Enter the "Start Date" / "Completion Date" :
                                      * The Rule : You must use Today's date minus 4 weeks .
                                      * Example: If today is April 19, enter March 22.
                                      * Press Enter . The system will calculate the next calls.
                                      * Verify the Package : Ensure the next upcoming call is indeed the 4 MON (4-month) Maintenance Package.
                                      * Save (Floppy Disk icon). This will generate a new Maintenance Order number.
                                      Step 3: Verify the Generated Maintenance Order
                                      You must now check that the order was created correctly based on the rules of your Task List (Task 7) and Maintenance Plan (Task 8).
                                      * Display Order : In IP10 , select the line for the generated call and click the Display Order icon (or use transaction IW33 with the new order number).
                                      * Check the following three items :
                                      * Operations : Verify there are exactly 2 operations in the order (the Monthly and 4-Month tasks).
                                      * Maintenance Plan : Confirm the order shows your specific Maintenance Plan number.
                                      * Task List : Verify the "Last Included Task List" is A / TL-48 / 1 .


                                      NEW QUESTION # 11
                                      Task 11: Classify a piece of Equipment
                                      The project team evaluates during the implementation project the classification of Technical Objects in order to use Checklists in SAP S/4HANA Asset Management. The following features need to be checked:
                                      * Assign a class to a Technical Object
                                      * Assign chararcteristic values to a class
                                      * Assign class EQ11 value to Technical Object T-PA## .
                                      * Assign a characteristic value, so that Inspection Plan Q / CL-DE-00 / 1 is automatically found during the checklist process

                                      Answer:

                                      Explanation:
                                      See the Explanation for complete Solution of this Task.
                                      Explanation:
                                      Task 11 Overview
                                      This task involves classifying a piece of equipment so it can be used in the Checklist process . By assigning a specific class and characteristic values, you enable the system to automatically find the correct inspection plan when a maintenance order is created.
                                      Step 1: Access the Equipment Master Record
                                      To classify the equipment, you must first open its master record in "Change" mode.
                                      * Transaction Code : Enter IE02 (Change Equipment) in the command field and press Enter .
                                      * Equipment : Enter T-PA48 .
                                      * Action : Press Enter to open the record.
                                      Step 2: Assign the Class to the Equipment
                                      Now you will link the equipment to a class that contains the required technical characteristics.
                                      * Navigate : Click the Classification button in the top toolbar (or go to the Classes tab if available).
                                      * Class Assignment :
                                      * Class Type : Ensure this is set to 002 (Equipment Class).
                                      * Class : Enter EQ11 .
                                      * Action : Press Enter . The system will now display the characteristics associated with class EQ11 in the bottom half of the screen.
                                      Explanation : Assigning a class is like giving the equipment a "category". Class EQ11 is specifically configured in this system to hold the data needed for checklist processing.
                                      Step 3: Assign Characteristic Values
                                      This is the critical step that tells the system exactly which inspection plan to use for this specific pump.
                                      * Locate the Characteristic : In the values table, look for a characteristic related to "Inspection Plan" or
                                      "Checklist Group."
                                      * Enter the Value : Assign the value so that Inspection Plan CL-DE-00 / 1 is automatically found.
                                      * Note: Typically, you will enter CL-DE-00 in the "Inspection Plan Group" field and 1 in the
                                      "Group Counter" field.
                                      * Action : Press Enter to validate the values.
                                      Explanation : Characteristic values are the specific details for this asset. By entering these values, you "tag" the equipment so that whenever it is added to a maintenance order, the system knows to look for the CL-DE-
                                      00 checklist automatically.
                                      Step 4: Save
                                      * Action : Click the Save (floppy disk) icon.
                                      * Confirmation : The system should display a message at the bottom saying: "Equipment T-PA48 changed."


                                      NEW QUESTION # 12
                                      Task 4: Configure and create Technical Objects
                                      The project team evaluates during the implementation project Technical Object structures in SAP S/4HANA Asset Management. The following features need to be checked:
                                      * Configure and create Functional Locations
                                      * Create, serialize and install Equipment
                                      * Create Functional Location master record ZZ0##-01 and save it. Use the following information:

                                      * Create Equipment master record EQUI-## and save it. Use the following information:

                                      * Serialize the just created Equipment master record EQUI-## . Use the following data:

                                      * Install Equipment EQUI-## at the Functional Location 00-01-ASS-02 .

                                      Answer:

                                      Explanation:
                                      See the Explanation for complete Solution of this Task.
                                      Explanation:
                                      Task 4: Configure and create Technical Objects
                                      This task evaluates your ability to structure and manage the physical and functional hierarchy of assets in SAP S/4HANA Asset Management.
                                      Step 1: Create Functional Location Master Record
                                      A Functional Location represents the area at which a maintenance task is to be performed.
                                      * Access the Transaction : Use transaction code IL01 (Create Functional Location).
                                      * Enter Initial Data :

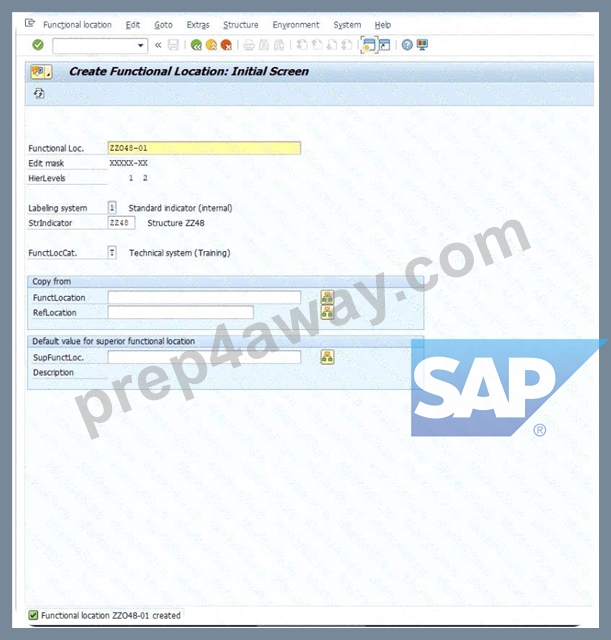

                                      * Functional Location : ZZ048-01.

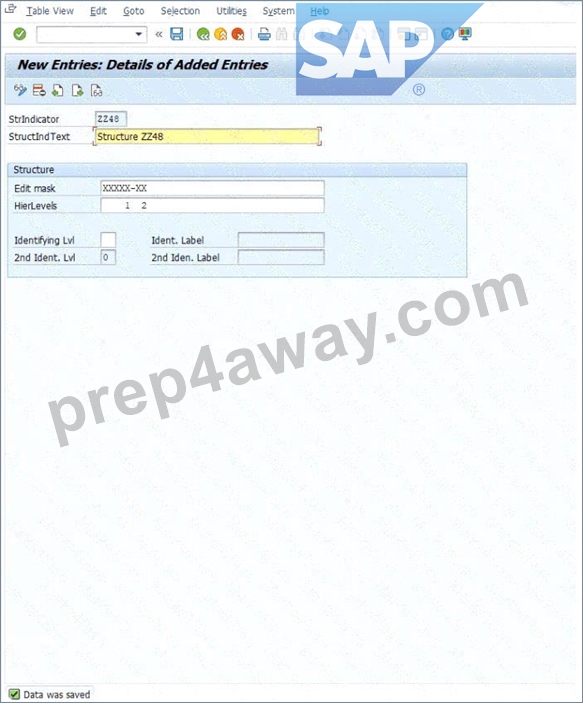

                                      * Structure Indicator : ZZ48.
                                      * Functional Location Category : T.
                                      * Press Enter .

                                      * Enter General Data :
                                      * Description : Production Line Z48.
                                      * Enter Location and Organization Data :
                                      * Maintenance Plant : 1020.
                                      * Cost Center : 4110.
                                      * Planning Plant : 1020.
                                      * Planner Group : Z48.
                                      * Main WorkCtr : T-ME48.
                                      * Work Center Plant : 1010.
                                      * Save : Click the Save icon.
                                      Explanation : By creating this record, you define a specific functional area within Plant 1020 where maintenance costs and history will be tracked for all equipment installed there.


                                      Step 2: Create Equipment Master Record
                                      Equipment represents an individual physical object that is maintained as an autonomous unit.
                                      * Access the Transaction : Use transaction code IE01 (Create Equipment).
                                      * Enter Initial Data :

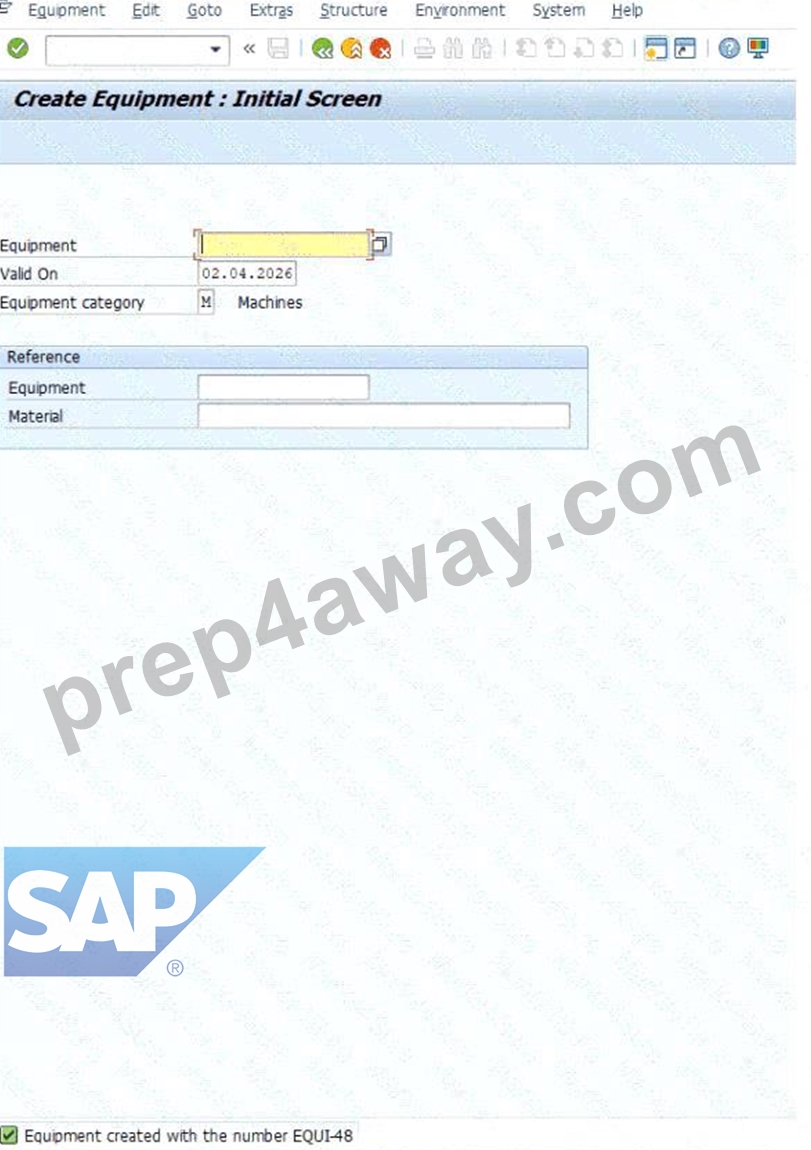

                                      * Equipment : EQUI-48.
                                      * Equipment Category : T.
                                      * Press Enter .

                                      * Enter General Data :
                                      * Description : Drive Motor GR48.
                                      * Save : Click the Save icon.
                                      Explanation : This step creates a master record for a physical asset-a drive motor-allowing you to track its individual lifecycle, independent of where it is currently installed.


                                      Step 3: Serialize the Equipment
                                      Serialization links a piece of equipment to a specific material and unique serial number for inventory management and tracking.

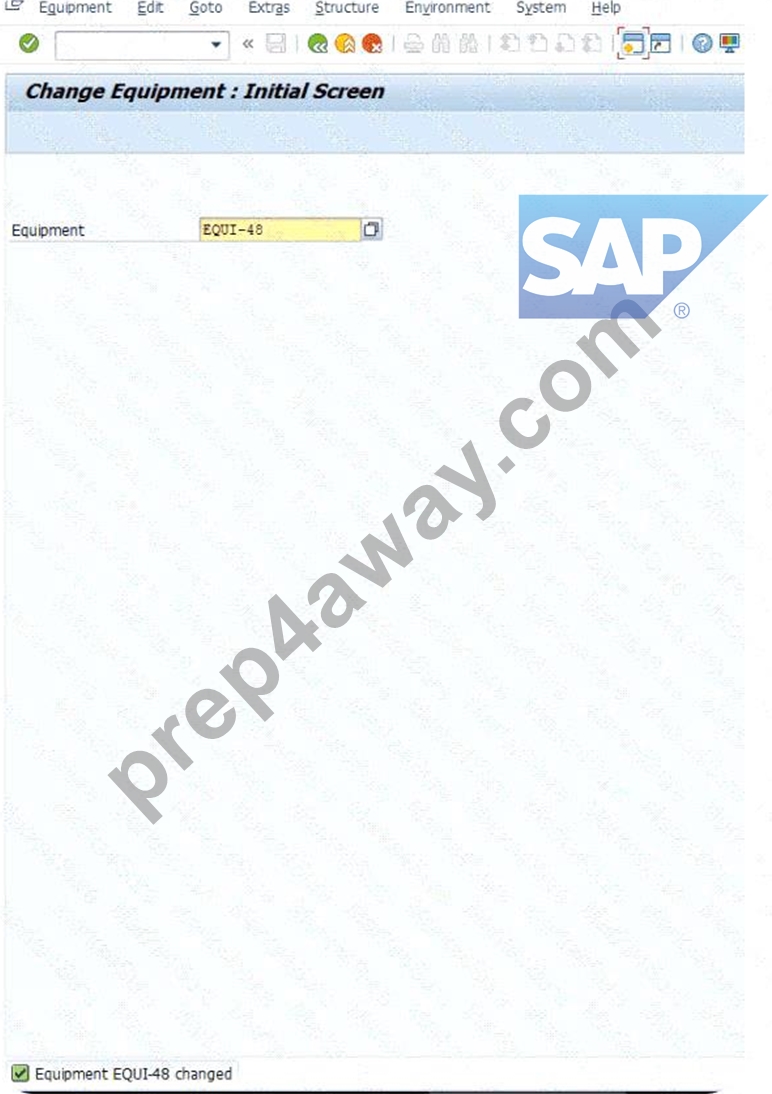

                                      * Access the Transaction : Use transaction code IE02 (Change Equipment) and enter EQUI-48.
                                      * Navigate to Serial Data : Go to the SerData (Serial Data) tab.

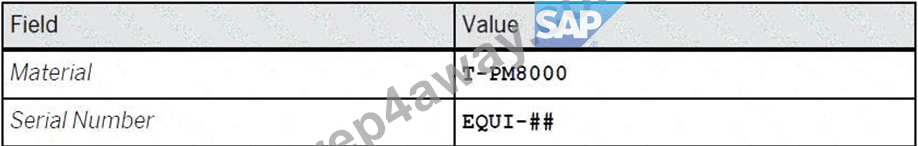

                                      * Enter Serialization Data :
                                      * Material : T-PM8000.
                                      * Serial Number : EQUI-48.
                                      * Save : Click the Save icon.
                                      Explanation : Linking the motor to Material T-PM8000 enables the system to track this specific asset as a serialized part, which is essential for warehouse movements and warranty tracking.

                                      Step 4: Install Equipment at a Functional Location
                                      This establishes the relationship between the physical asset (Equipment) and the functional area where it is operating.
                                      * Access the Transaction : Use transaction code IE02 (Change Equipment) for EQUI-48.
                                      * Modify Installation Location :
                                      * Click on the Structure tab.
                                      * Find the FunctLoc field.
                                      * Enter the location: 00-01-ASS-02.
                                      * Save : Click the Save icon.
                                      Explanation : This installation "plugs" your drive motor into the functional hierarchy at location 00-01-ASS-02. From this point forward, any maintenance performed on this motor will be automatically associated with that location's history.


                                      NEW QUESTION # 13
                                      In the following assessment you will slip into the role of a consultant implementing SAP S/4HANA Asset Management OnPrem/Private Cloud for Machine Manufacturing Inc. . You need to fulfill various system tasks to setup certain business processes and test them.
                                      Note:
                                      In the task descriptions is no information provided if and/or how Asset Management specific customizing settings need to be adapted. This is an implicit part of the exam.
                                      Note:
                                      There is no information provided which UI to use when creating the data in the system e.g. SAP GUI, SAP Fiori Launchpad. This is an implicit part of the exam.
                                      Your performance in each exercise will be evaluated to produce an overall score that determines a pass or fail for the exam. Please read every exercise carefully and enter any data exactly as requested without alteration. Some input data is provided in tables or in the task descriptions, however your input data is not limited to these parameters.
                                      Use the following Logon information for all tasks:

                                      Caution:
                                      Please make sure you are always using your assigned group number (denoted as ## in the following) .
                                      Your results will not be recorded if you are not using your own group number.
                                      For example, if your group number is 10 i.e. (## = 10), your user will be S43900-10.
                                      To find your group number: Click the Access button on the practice system details page. You will find your group number displayed beneath the "Get started" header in the pop-up window. Alternatively, in your Windows Terminal Server, choose the Windows button in the lower left corner. The Start Menu opens. It its upper left corner, choose the Expand icon (three white lines). Find your user name next to the user icon on the left side of the menu - the last two digits of the user name are your group number ##.
                                      Note:
                                      To access your backend system in the Windows Terminal Server, open the SAP Logon application and start the T41 system (Client 400 ). You can access the SAP Fiori Launchpad from the SAP Menu in T41. Always work with user S43900-## in order to have the required roles in place for your tasks.
                                      Caution:
                                      To keep the system running smoothly and avoid unnecessary costs, please follow the assigned exercises carefully when using the SAP Landscape. Avoid going beyond the exercise scope and stay within your allocated resources to help maintain a stable and efficient environment for everyone and to ensure your data is evaluated properly.
                                      Note:
                                      In the following, you will be asked to create new transaction data, among others. If you are asked to create one specific new transaction data object, and - for whatever reason - you create more than one of that kind, SAP will evaluate your newest version only. For example: if you are asked to create a Maintenance Order of a specific Order Type in an exercise and you create three different Maintenance Orders of a specific Order Type, only your order with the highest order number will be evaluated.

                                      Answer:

                                      Explanation:
                                      See the Explanation for complete Solution of this Task.
                                      Explanation:
                                      Task Objective
                                      In this assessment, you assume the role of a consultant implementing SAP S/4HANA Asset Management for Machine Manufacturing Inc. . Your goal is to set up and test specific business processes through various system tasks.
                                      Step 1: Identify Your Assigned Group Number (##)
                                      This is the most critical step, as your results will only be recorded if you use your specific group number, denoted as ## in all instructions.
                                      How to find your number:
                                      * Method A: Click the Access button on the practice system details page; your group number is displayed beneath the "Get started" header.
                                      * Method B: In the Windows Terminal Server, click the Windows button (Start Menu), select the Expand icon (three white lines), and find your user name next to the user icon. The last two digits of that name are your group number.
                                      Step 2: Access the System
                                      You must use the specific credentials provided to ensure you have the required roles for the assessment.
                                      Logon Credentials:
                                      * System : T41
                                      * Client : 400
                                      * User Name/ID : S43900-## (e.g., if your group number is 10, use S43900-10)
                                      * Password : Welcome1
                                      Connection Methods:
                                      * SAP GUI : Open the SAP Logon application in the Windows Terminal Server and start the T41 system (Client 400).
                                      * SAP Fiori Launchpad : This can be accessed directly from the SAP Menu within the T41 system.
                                      Step 3: Understand Implicit Exam Rules
                                      The assessment does not provide exhaustive instructions; certain technical decisions are considered part of the exam.
                                      * Customizing : You must determine if and how specific Asset Management customizing settings need to be adapted.
                                      * User Interface : You are free to choose between the SAP GUI or SAP Fiori Launchpad to create data, as the instructions do not specify which to use.
                                      * Data Accuracy : Enter all data exactly as requested in the tables or descriptions without any alterations.
                                      Step 4: Evaluation of Transaction Data
                                      If you are asked to create a specific transaction object (like a Maintenance Order) and you create multiple versions, the system will only evaluate the newest version (the one with the highest identifying number).
                                      Caution : To ensure your data is evaluated properly and to maintain system stability, stay strictly within the scope of the assigned exercises and your allocated resources.


                                      NEW QUESTION # 14
                                      Create a Task List
                                      The project team evaluates during the implementation project Task Lists in SAP S/4HANA Asset Management. The following features need to be checked:
                                      * Create a Task List header
                                      * Create Task List operations
                                      * Create a Task List with 3 Task List operations. Maintenance Strategy Z## comprises Maintenance Packages with different hierarchy levels.
                                      Use the following information at header level of the Task List:

                                      Use the following information for each Task List operation:

                                      * Assign Maintenance Packages to the Task List Operations as follows:
                                      * Operation 10 is to be performed monthly.
                                      * Operation 20 is to be performed every 4 months.
                                      * Operation 30 is to be performed every 12 months.

                                      Answer:

                                      Explanation:
                                      See the Explanation for complete Solution of this Task.
                                      Explanation:
                                      Since we encountered that error with the Z48 strategy , we must ensure that is fixed before we can finish the Task List. Here is the complete, verified, step-by-step process to finalize Task 7 , including the "hidden" pre- requisite.
                                      Task 7: Create a General Task List
                                      Objective : To create a standardized template of maintenance steps that can be automatically pulled into future work orders based on a schedule.
                                      Step 1: The Pre-requisite (Fixing Strategy Z48)
                                      If you haven't done this yet, SAP will not let you save the Task List.
                                      * Transaction : IP11 (Maintain Maintenance Strategies).
                                      * Action : Click New Entries .
                                      * Strategy : Z48
                                      * Description : Strategy for Group 48
                                      * Strategy Unit : MON (Months).
                                      * Packages : On the left, double-click Packages , then click New Entries :
                                      * Line 1 : Cycle 1 / Unit MON / Text Monthly
                                      * Line 2 : Cycle 4 / Unit MON / Text Every 4 Months
                                      * Line 3 : Cycle 12 / Unit MON / Text Yearly
                                      * Save (Floppy Disk icon).
                                      Explanation : A strategy is the "calendar" that defines how often work happens. Without this, the system doesn't know what "Monthly" or "Yearly" means.
                                      Step 2: Create Task List Header
                                      * Transaction : IA05 .
                                      * Initial Screen : Group TL-48, Group Counter 1. Press Enter .
                                      * Header Fields :
                                      * Description : Regular Maintenance GR48
                                      * Planning Plant : 1010
                                      * Work Center : MK-00 / Plant : 1010
                                      * Usage : 4 (Plant Maintenance)
                                      * Status : 4 (Released)
                                      * Planner Group : P48
                                      * Maint. Strategy : Z48
                                      Explanation : The header defines who is responsible for the work (Planner Group P48) and which scheduling rules (Strategy Z48) apply to the whole list.
                                      Step 3: Create Operations
                                      * Click the Operations button (F6) at the top.
                                      * Enter three rows with this data:
                                      * Op 10 : Work Center MK-00, Plant 1010, Control Key PM01, Work 30, Unit MIN.
                                      * Op 20 : (Same as above).
                                      * Op 30 : (Same as above).
                                      Explanation : Operations are the actual steps the technician follows. Here, we are saying each step takes 30 minutes of mechanical labor.
                                      Step 4: Assign Maintenance Packages (The "Frequencies")
                                      This is the most important part of Task 7. We tell SAP which operation happens when.
                                      * Select Row 10 (click the box at the far left of the row).
                                      * Go to Menu: Goto > Maintenance Packages .
                                      * Check the box for the 1 Month package. Click the Back (Green Arrow) icon.
                                      * Select Row 20 .
                                      * Go to Goto > Maintenance Packages and check the 4 Month package. Click Back .
                                      * Select Row 30 .
                                      * Go to Goto > Maintenance Packages and check the 12 Month package. Click Back .
                                      Explanation : Now, SAP knows that Op 10 happens every month, but Op 30 only happens once a year.
                                      Step 5: Save
                                      * Click the Save icon.
                                      * The message at the bottom should say: "Task list TL-48 saved with group counter 1" .


                                      NEW QUESTION # 15
                                      ......

                                      In our software version of the C_S43_2601 exam dumps, the unique point is that you can take part in the practice test before the real C_S43_2601 exam. You never know what you can get till you try. It is universally acknowledged that mock examination is of great significance for those who are preparing for the exam since candidates can find deficiencies of their knowledge as well as their shortcomings in the practice test, so that they can enrich their knowledge before the Real C_S43_2601 Exam.
